An investor has a comprehensive business plan for a new manufacturing facility in Uruguay: the market analysis is sound, financial projections are robust, and the technology has been selected.
Yet a critical variable is often underestimated: the timeline and complexity of securing an environmental operating license. This common and costly oversight can delay a project’s start by months, or even years.
For entrepreneurs and companies entering Uruguay’s industrial sector, particularly in specialized fields like solar module manufacturing, the environmental approval process is far more than a last-minute bureaucratic hurdle; it is a foundational component of the project’s strategic plan. Understanding this regulatory pathway, managed by the Ministry of Environment, is essential for accurate budgeting and timeline forecasting, paving the way for a successful launch.
This guide breaks down the process in clear, business-focused terms, outlining the steps from initial project submission to final operational approval.
Understanding Uruguay’s Environmental Framework: The Role of DINACEA
The primary regulatory body overseeing environmental matters in Uruguay is the National Directorate for Environmental Quality and Assessment (Dirección Nacional de Calidad y Evaluación Ambiental – DINACEA), which operates under the Ministry of Environment. This agency was previously known as the National Environment Directorate (DINAMA), a name that may still appear in older documentation.
DINACEA’s mandate is to ensure that new industrial projects, including factories, are developed sustainably and in compliance with national environmental law (specifically Law No. 16.466). Its role is not to block development, but to classify projects based on their potential environmental impact and guide them through a corresponding approval process. For an investor, engaging with DINACEA’s requirements from the outset is a critical step toward de-risking the project.
The Three Pathways to Approval: Project Categorization
DINACEA classifies all new projects into one of three categories—A, B, or C—based on the significance of their potential environmental impact. This classification determines the complexity and duration of the licensing journey.
Category ‘A’ Projects
These are projects with a low or negligible environmental impact. The process is typically straightforward, often requiring only a notification and basic documentation to secure a permit. For a new factory, this category would likely apply only to minor renovations or expansions of an existing, already licensed facility.
Category ‘B’ Projects
Projects with a moderate potential impact fall into this category, which is the most probable classification for a new, medium-sized solar panel assembly factory (e.g., 20-100 MW capacity). These projects require a formal Prior Environmental Authorization (Autorización Ambiental Previa – AAP) before any construction can begin. The process involves submitting a detailed project description and a focused environmental impact assessment that analyzes specific potential effects and proposes mitigation measures.
Category ‘C’ Projects
This category is reserved for large-scale projects with a high potential for significant environmental impact, such as major chemical plants, large dams, or mining operations. These projects require a full, comprehensive Environmental Impact Assessment (Estudio de Impacto Ambiental – EIA) and are subject to a mandatory public hearing. A standard solar module assembly factory, which primarily involves assembly rather than raw chemical processing, is unlikely to be classified as Category ‘C’.
The Step-by-Step Licensing Journey for a New Solar Factory (Category B)
Assuming a new solar module factory is classified as Category ‘B’, the investor must navigate a multi-stage process to secure full operational approval.
Step 1: Initial Filing – Project Communication (Comunicación de Proyecto)
The process begins with submitting a ‘Project Communication’ form to DINACEA. This document provides a high-level overview of the proposed factory, including its location, size, production process, and basic inputs and outputs (e.g., water, energy, waste).
Step 2: Official Classification
Based on the Project Communication, DINACEA formally classifies the project into Category A, B, or C. This official determination, issued as a formal resolution, confirms the specific regulatory path the project must follow and marks a key early milestone.
Step 3: Application for Prior Environmental Authorization (Solicitud de AAP)
Once classified as ‘B,’ the core of the work begins. The investor must prepare and submit an application for the AAP. This is a substantial package that includes:
- A detailed engineering plan for the factory layout and operations.
- An analysis of potential environmental impacts (e.g., water usage, waste generation, noise).
- A corresponding Environmental Management Plan outlining how these impacts will be managed, mitigated, and monitored.
Based on experience from J.v.G. turnkey projects, the quality and completeness of this submission are the single most important factors determining the speed of the approval process.

Step 4: Public Information Phase (Puesta de Manifiesto)
To ensure transparency, DINACEA makes the AAP application and environmental assessment available for public review for a set period. This standard procedural step, managed by the agency, allows local communities and stakeholders to review the project’s details and submit comments.
Step 5: Securing the Operational Authorization (Autorización Ambiental de Operación – AAO)
The AAP grants the right to build and install the factory, but not to operate it. For that, once construction is complete and all equipment is installed, the investor must apply for the Environmental Authorization for Operation (AAO). This final stage involves an inspection by DINACEA to verify that the factory was built according to the approved plans and that all environmental management systems are in place. Only after the AAO is granted can commercial production begin.
Key Success Factors for Investors
Navigating this process efficiently requires a strategic approach that goes beyond simply submitting paperwork.
-
Engage Early and Professionally: The environmental licensing process should be initiated in parallel with site selection and initial engineering. Engaging qualified local environmental consultants who are experienced with DINACEA’s procedures is not an optional expense; it is a critical investment.
-
Plan for Realistic Timelines: For a Category ‘B’ project, expect the full process—from initial filing to receiving the final AAO—to take anywhere from 9 to 18 months, depending on project complexity and submission quality. This timeline must be factored into the overall project business plan.
-
Maintain Thorough Documentation: Delays in the process are most often caused by requests for additional information from DINACEA. Preempting these requests with a comprehensive, well-researched, and professionally prepared AAP application is the best way to demonstrate diligence and keep the project on track.

Frequently Asked Questions (FAQ) for Factory Planning in Uruguay
Q: How long does the entire environmental approval process take in Uruguay?
A: For a standard Category ‘B’ industrial project, a realistic estimate is 9 to 18 months from the initial project communication to receiving the final Authorization for Operation (AAO). This timeframe can be extended by project complexities or incomplete submissions.
Q: What are the main costs associated with environmental licensing?
A: Costs include government application fees, but the most significant expense is typically for the local environmental consultants who prepare the environmental impact study and manage the application process. Investing in these professional fees is essential for a smooth and successful outcome.
Q: Can any site work or construction begin before receiving the Prior Environmental Authorization (AAP)?
A: No. The AAP is the legal prerequisite for any physical construction or site alteration. Starting work without it can lead to significant fines and legal complications, jeopardizing the entire project.
Q: Is a solar panel assembly factory always classified as Category ‘B’?
A: While it is the most likely classification, it is not guaranteed. Factors such as the factory’s proposed location (e.g., near a sensitive ecosystem), its scale, or specific processes involving chemicals could potentially elevate it to Category ‘C’. The final decision rests with DINACEA.

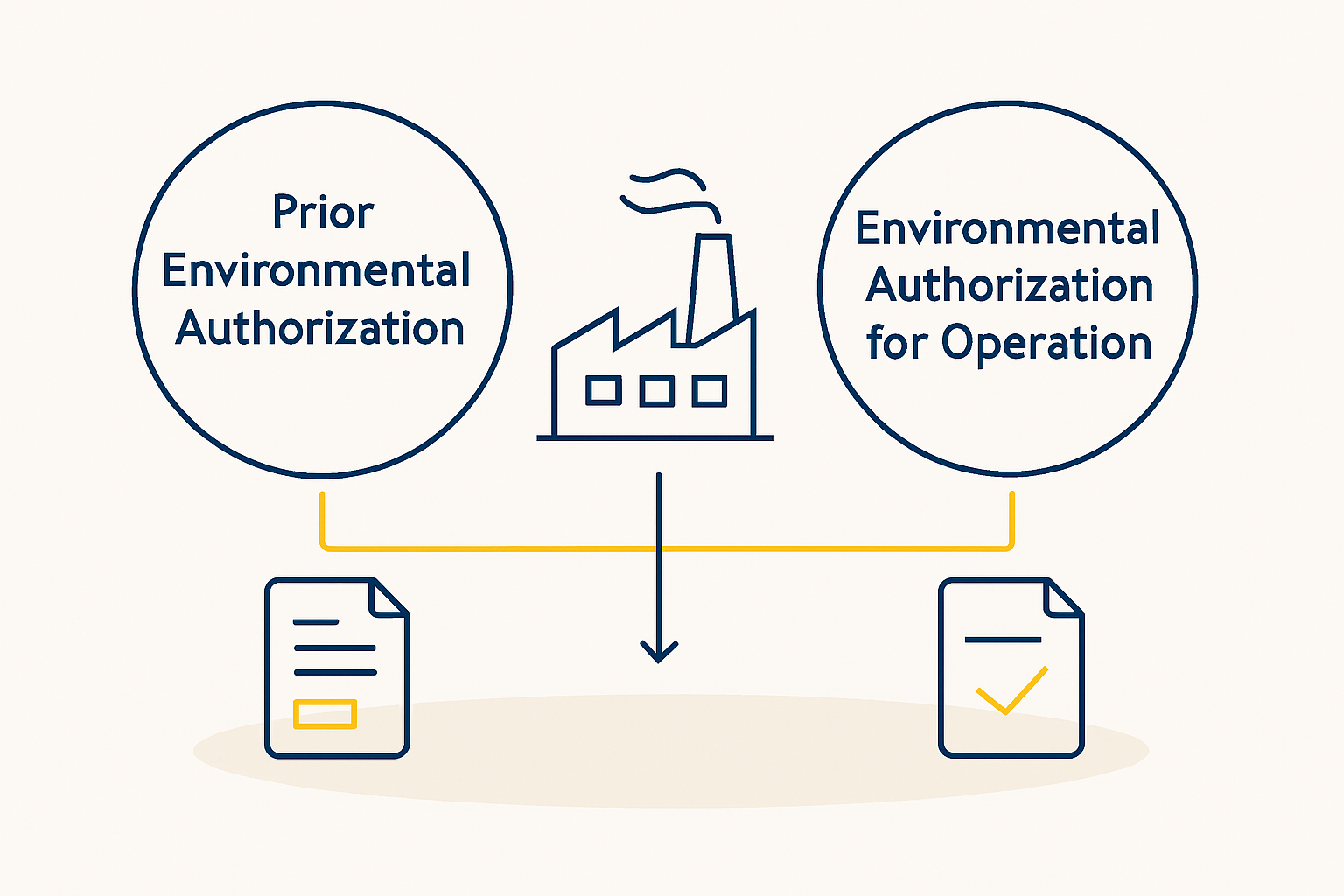

Q: What is the difference between the AAP and the AAO?
A: The AAP (Prior Environmental Authorization) grants permission to build the factory, while the AAO (Environmental Authorization for Operation) grants permission to operate it once construction is complete and DINACEA has verified that it meets all commitments made in the AAP application.
Conclusion: Integrating Environmental Strategy into Your Business Plan
The environmental licensing pathway in Uruguay is well-defined and predictable for those who prepare for it. Success depends on viewing this process as an integral part of the business strategy, not just a final administrative task.
Understanding DINACEA’s classification system, planning for a realistic timeline, and allocating resources for expert guidance are key to navigating the process efficiently. Properly managing this regulatory journey does more than ensure compliance; it establishes a foundation for a resilient, sustainable, and well-regarded industrial operation for years to come. It is the first step in demonstrating a commitment to the long-term economic and environmental well-being of the region where you invest.
